Interstate 42

Proposed Routing
U.S. 70 between Raleigh and Morehead City plays important roles, including being a primary hurricane evacuation route as well as being a major corridor for freight transport. The Interstate 42 corridor generally follows U.S. 70 southeasterly, connecting Garner, Clayton, Smithfield, Selma, Goldsboro, Kinston, New Bern and Havelock with the Port of Morehead City.
I-42 begins at a systems interchange with I-40 and Toll NC 540 (South Wake Expressway) near Garner and follows the Clayton Bypass southeast to U.S. 70 near Powhatan. U.S. 70 overtakes the freeway east to U.S. 70 Bypass at Selma. This section is not built to interstate standards, as a right in right out (RIRO) intersection with W Oak Street in Selma is one the deficiencies to be addressed.
Future I-42 follows U.S. 70 Bypass across I-95 between Selma and Smithfield. U.S. 70 rejoins the freeway south from Selma to U.S. 70 Business, where the freeway transitions to an at-grade expressway. Designated as Interstate 42 in Fall 2024, the next section of limited access highway along the U.S. 70 corridor is the Goldsboro Bypass. Extending 21.7 miles east to U.S. 70 near La Grange, this was formerly designated U.S. 70 Bypass.
A proposed 11.89 mile long bypass will take I-42 around the south side of Kinston, connecting with the existing controlled access and freeway portions of U.S. 70 east to New Bern. Southeast of New Bern, Future I-42 follows the Havelock Bypass west of Havelock. Ultimately I-42 will end near the Port of Morehead City.
In addition to connecting Morehead City with the Raleigh area, I-42 would also link Seymour Johnson Air Force Base and Cherry Point Marine Corps Air Station to the Interstate system.
The American Association of State Highway and Transportation (AASHTO) officials at the Fall 2021 meeting approved the request by the North Carolina Department of Transportation (NCDOT) for the establishment of Interstate 42 along 21.56 miles across Wayne and Lenoir Counties. NCDOT subsequently received approval by the Federal Highway Administration (FHWA) on March 16, 2022 to designate I-42 along two separate segments. The western section overlays U.S. 70 for ten miles in Johnston County from I-40 east to U.S. 70 Business / Exit 326Â south of Clayton. The eastern section stretches 22 miles covering all of U.S. 70 Bypass to the north of Goldsboro and on a portion of U.S. 70 east to the exchange with NC 903 / Exit 372 near La Grange.5
Route Information
Future Interstate 42 corridor signs were posted at the eventual west end of the route along the Clayton Bypass in 2016. 12/15/16
Converting U.S. 70 to Interstate 42
The remaining controlled-access portions of U.S. 70 between Clayton and Morehead City are gradually being upgraded to freeway standards, and as each new section is constructed or upgraded, they will be submitted for inclusion into the Interstate system. Projects currently underway or planned for Interstate 42 include:
- U.S. 70 Goldsboro Bypass – from just west of NC 581 in Wayne County to just east of Promise Land Road in Lenoir County. Built in three stages, the western half of the 20 mile long bypass was complete from U.S. 70 in Wayne County to Wayne Memorial Drive by October 2015. The remaining 12.5 mile connection back to U.S. 70 in Lenoir County opened May 27, 2016.4 An additional 6.7 miles of U.S. 70 will be upgraded to Interstate standards from the Goldsboro Bypass to Princeton once funding is made available.
- U.S. 70 Kinston Bypass – previously unfunded per the NCDOT 2016-2025 State Transportation Improvement Plan,2 the 2018-27 plan allocates $381.1 million for the project. A southern alternative of a U.S. 70 bypass near Kinston was preferred over several northern alternatives. Estimated costs were $181 million.2 Alternative 1SB was selected and a Final Environmental Impact Statement (FEIS) and Record of Decision (ROD) was previously expected in 2022-23. Right of way acquisition was anticipated for 2026 with construction to be determined. However due to a lack of funding, the FEIS is now anticipated for 2026 and the ROD in 2027.
- U.S. 70 Improvements in James City – this project makesimprovements to the U.S. 70 corridor through the James City area from south of the exchange with U.S. 17 to south of Garner Road. Construction on the $322 million project runs from Spring 2022 to
late 2024mid-2027. - U.S. 70 Havelock Bypass – from north of the Havelock City limits and extending south for approximately 10 miles to north of the Craven-Carteret county line. At an estimated cost of $323 million, construction on the limited access bypass started in September 2019. The bypass opened to traffic on December 19, 2025 while punch list work extends through Winter 2026.
U.S. 412 in Oklahoma and Arkansas
The Oklahoma Department of Transportation (ODOT) and Arkansas Department of Transportation (ARDOT) submitted applications to AASHTO for the Fall 2023 Meeting of the Route Numbering Committee to establish U.S. 412 between I-35 in Noble County, OK and to I-49 in Springdale, AR as Interstate 42. The proposed route is 190 miles in Oklahoma, using the Cimarron Turnpike east toward Tulsa and the Cherokee Turnpike east beyond Tulsa. The proposed 11 miles in Arkansas include Arkansas Route 612 along the Springdale Northern Bypass.
The premise behind numbering U.S. 412 as I-42 along this corridor relates to the similarity in numbers. However, with an already established Interstate 42 in North Carolina, AASHTO approved the application with condition. The numbering conveys that the two corridors may be joined at some point, which is not going to be the case. As such, both states withdrew their respective applications for further review.
High Priority Corridor
Proposed Interstate 42 is part of the Fixing America’s Surface Transportation (FAST) Act high priority future Interstate corridor, which is designated as Corridor 82.
History
Defined as High Priority Corridor #82 from the December 2015 Fixing America’s Surface Transportation (FAST) Act, U.S. 70 between Garner and Morehead City became designated as a future interstate corridor. While a few designations were proposed (I-46 by the Transportation Alliance and I-50 by the Super 70 Corridor Commission), the North Carolina Department of Transportation (NCDOT) had submitted Interstate 36 for the 137 mile long corridor. The I-36 proposal was discussed at the May 24, 2016 American Association State Highway and Transportation Officials (AASHTO) Special Committee on U.S. Route Numbering meeting, but instead of the I-36 designation, AASHTO officials approved Interstate 42 for the U.S. 70 corridor.3 With an official number assigned for the corridor between I-40 and Morehead City, “Future I-42” signs could be installed along various segments, pending approval from the Federal Highway Administration (FHWA).3
Also, unlike Interstate 36, the I-42 designation fits into the Interstate system number grid, following a course completely north and east of I-40.
Photo Guides
East End

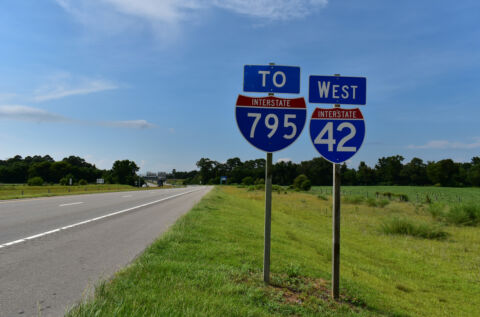

– La Grange, North Carolina
The eastern end of Interstate 42 will eventually connect with U.S. 70 in the Morehead City area. The easternmost freeway portion completed is the Havelock Bypass, which ties into U.S. 70 north of Newport.

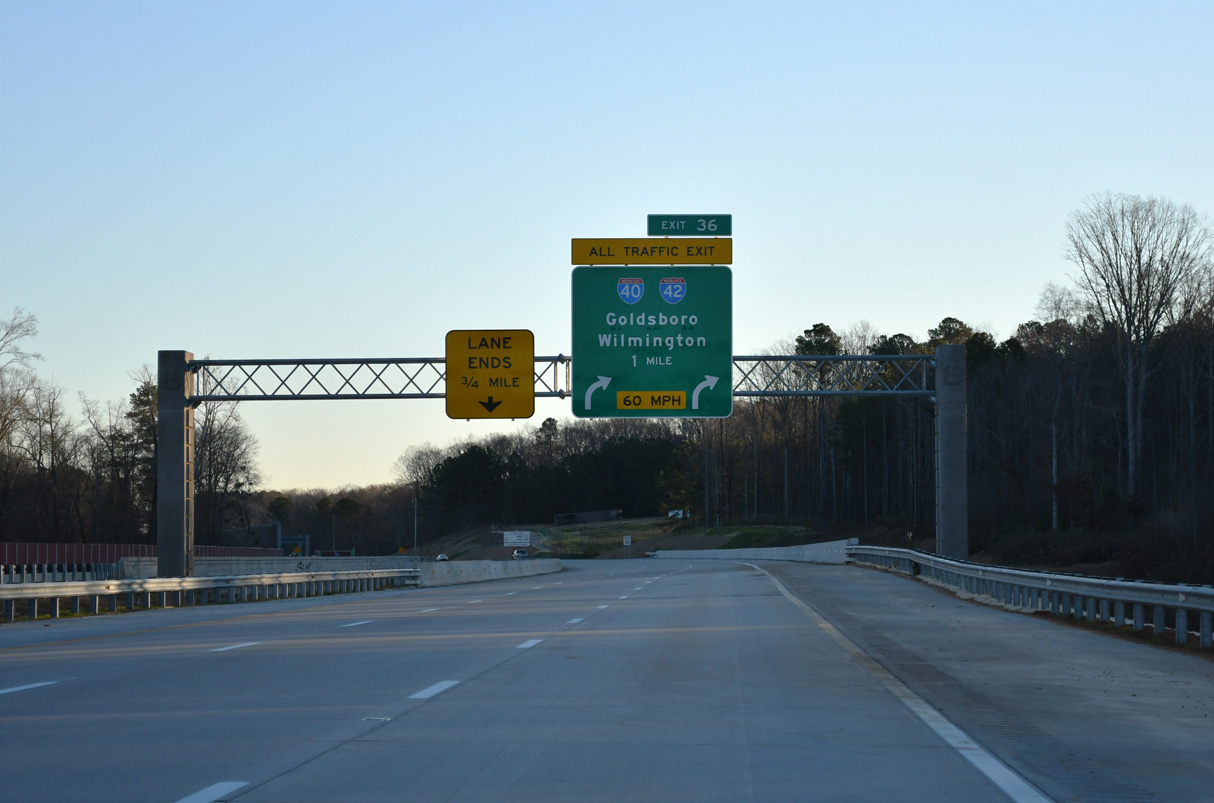

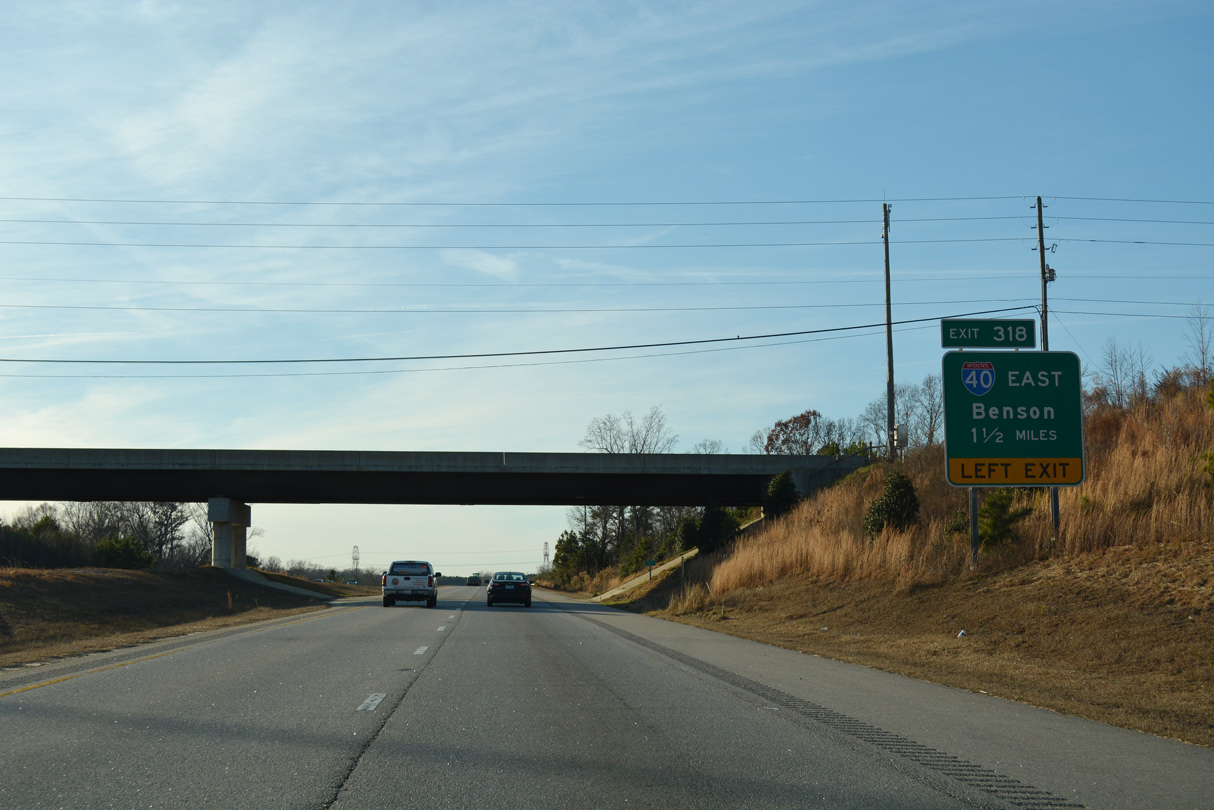

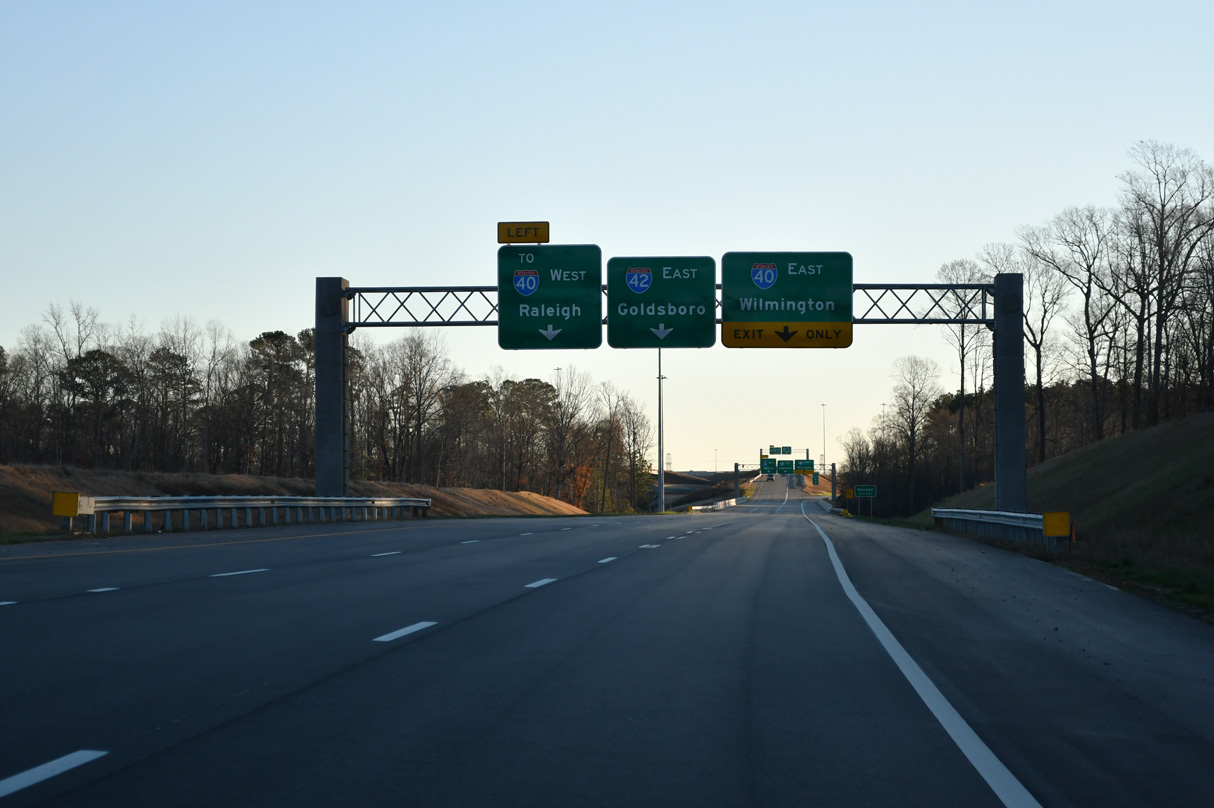

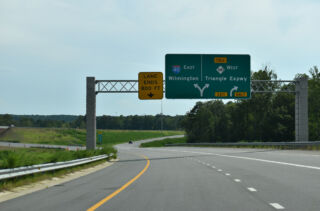

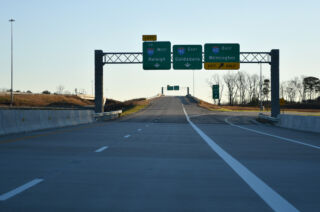

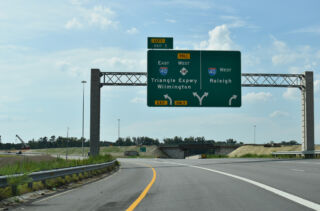

West at
West End
 – Garner, North Carolina
West at

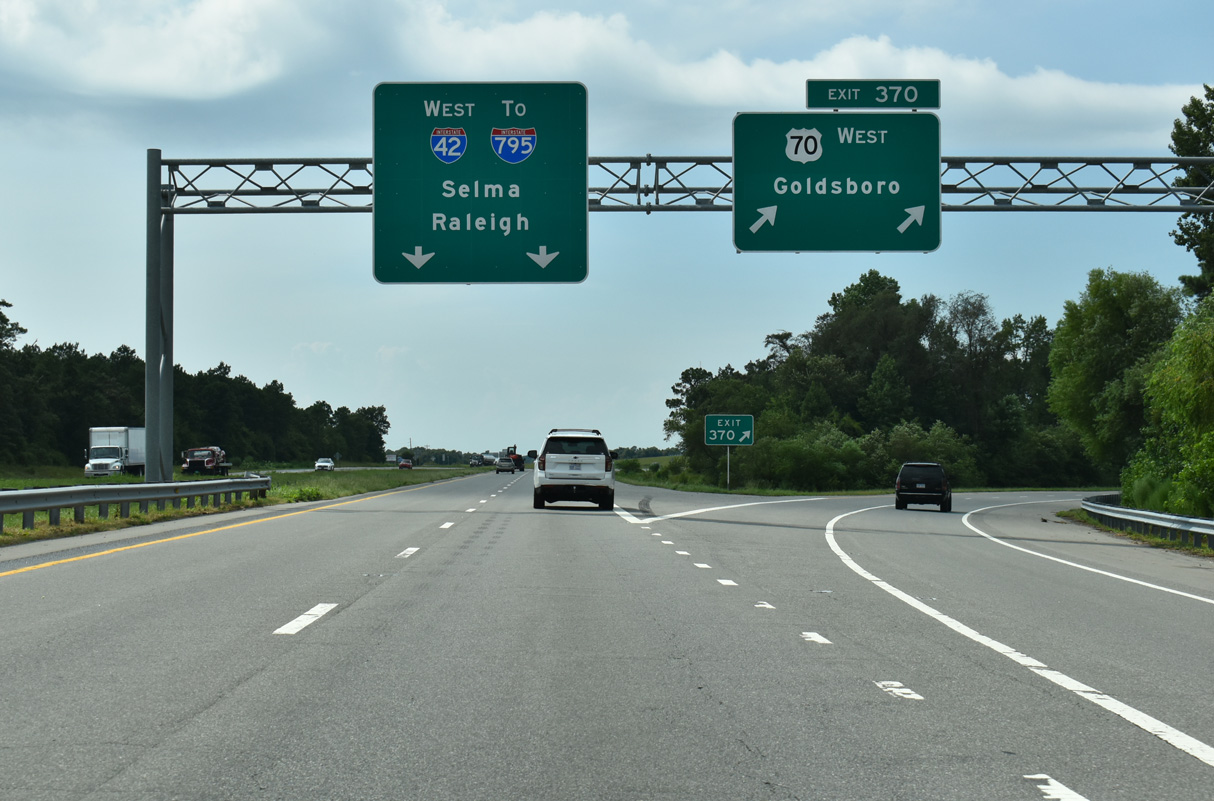

East at
